If you live in Saint Cloud, FL, your pool is exposed to year-round sun, heavy rain, humidity, and constant use. Over time, even the best-built pools begin to show signs of wear—fading color, rough surfaces, stains, and small cracks that slowly become bigger problems.
Pool resurfacing is not just about aesthetics. It’s about restoring the structural integrity of your pool, improving safety, and extending its lifespan. For homeowners in Central Florida, resurfacing is one of the most important maintenance investments you can make.
In Saint Cloud, pool resurfacing demand has increased as homeowners prioritize outdoor living spaces that feel modern, clean, and resort-like. Whether you are dealing with an older plaster finish or upgrading to PebbleTec, the right contractor makes a significant difference in durability and long-term performance.
Pool resurfacing in Saint Cloud, FL typically involves removing the old surface, repairing the structure, and applying a new finish such as plaster, quartz, or PebbleTec. The process usually takes 5–7 days depending on pool size and material choice. It improves durability, appearance, and water quality while extending the pool’s lifespan.
Step-by-Step Pool Resurfacing Timeline: What Happens Each Day
Most homeowners picture a crew showing up, working for a few days, and leaving with a finished pool. The reality is more structured than that and understanding each phase is exactly what separates a smooth project from a frustrating one.
Day 1 — Draining and surface removal.

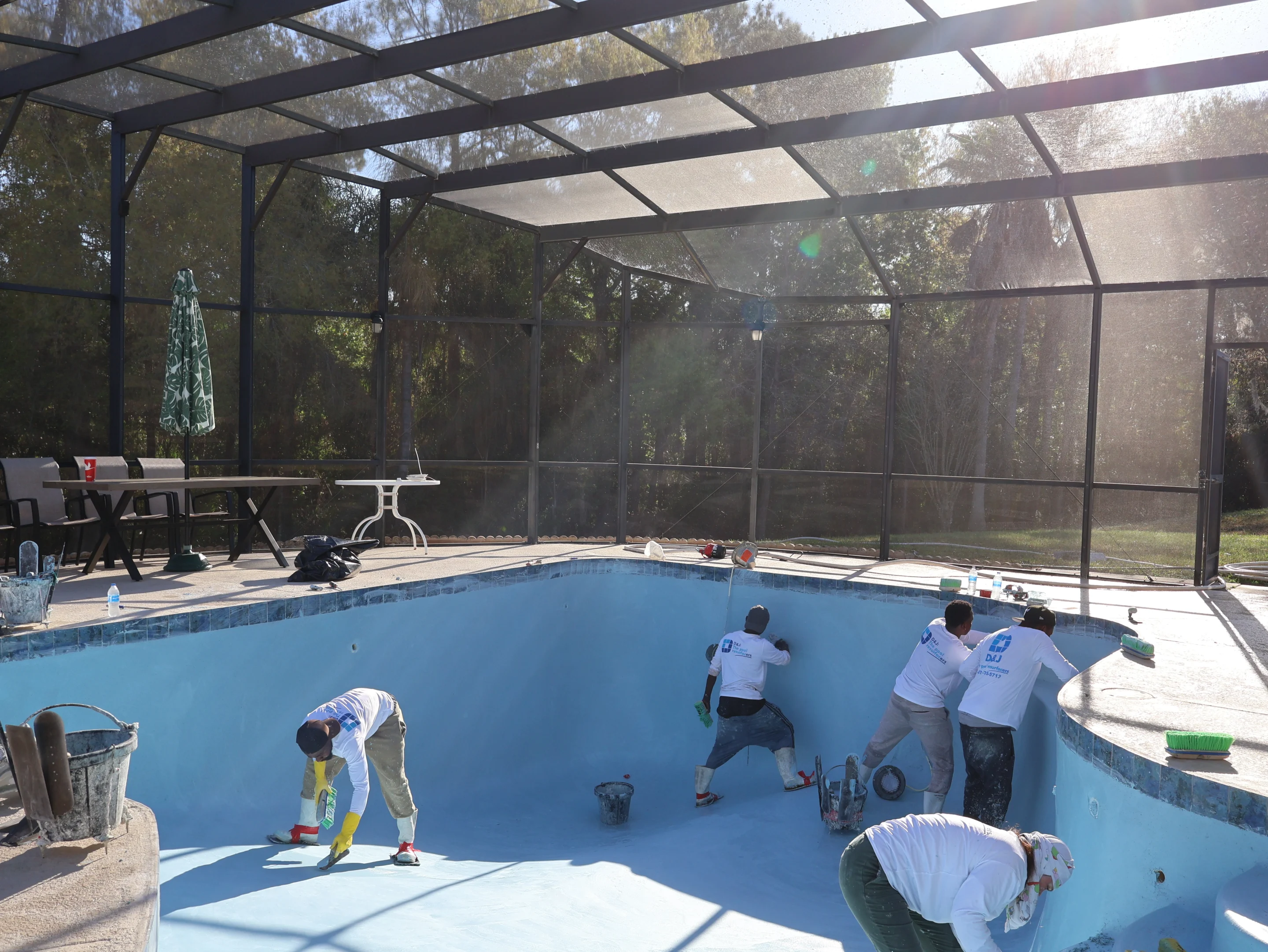

The pool is drained completely. Then the old surface plaster, pebble, or whatever finish is there is removed down to the concrete shell. This is the phase that determines everything that follows. A proper removal exposes the shell fully so that any cracks, delamination, or structural issues can be identified and addressed before new material goes on. Contractors who rush this step are cutting a corner that the surface will pay for in two or three years.
Days 2 and 3 — Repairs and preparation.
Any cracks or imperfections in the shell are addressed. The surface is prepared, cleaned, profiled, and treated so that the new finish bonds correctly. This phase varies in duration depending on what the shell reveals once the old surface is off. A pool in good structural condition moves through this phase quickly. A pool with significant surface damage requires more time here, and that time is not wasted, it’s what makes the new surface last.
Day 3 or 4 — Application of the new finish.
PebbleTec, Quartz, or plaster is applied to the prepared shell. For PebbleTec and Quartz, this requires certified applicators; the material has specific application requirements that affect how it looks and how long it lasts. D&J holds that certification. The application phase is typically completed in one working day for a standard residential pool.
Days 4 through 6 — Initial cure and fill.
After application, the surface needs a brief curing window before the fill begins. Once filling starts, it runs continuously without interruption stopping partway through can leave a permanent waterline mark on a fresh surface. A standard Central Florida pool fills in 12 to 24 hours depending on water pressure and pool size.
Weeks 2 through 5 — Chemical startup.
The pool is full. The work crew is gone. And the process is still not finished. The chemical startup period covered in detail in the next section runs approximately four weeks and is as important as any day of physical work. This is the phase most homeowners don’t hear about clearly enough before the project starts.
From drain to done: plan for 3 to 4 working days of hands-on work, plus four weeks of startup. The first swim happens around week two for most homeowners if the startup is managed correctly.
Why Curing Time Is the Phase That Determines How Long Your New Surface Lasts?
Here’s something that surprises almost every homeowner who goes through this process for the first time.
The moment the crew finishes and the pool starts filling isn’t the end of the project. It’s the beginning of the most chemically sensitive phase, the period where what happens in the water determines whether that new surface lasts 5 years or 25.
A new pool surface whether PebbleTec, Quartz, or plaster is a cementitious material. It continues to cure and harden after it’s applied, after the water goes in, and for weeks into the startup period. During that time, the material is doing something specific: it’s releasing minerals and compounds into the water as it hardens, and the water chemistry is simultaneously conditioning the surface. That interaction has to be managed carefully. If it isn’t, the results show up fast.
Calcium scaling that forms on a fresh surface during an improperly managed startup is significantly harder to remove than scaling on a mature surface because the surface itself is still hardening and more vulnerable to the aggressive treatments needed to remove deposits. Staining that develops in the first two weeks of a startup can become permanent in ways that staining on a three-year-old surface wouldn’t.
This is why daily brushing of the entire pool surface during the first week to ten days of the startup isn’t optional; it’s part of the curing protocol. Brushing helps the surface cure evenly, prevents calcium from concentrating in one area, and keeps the water moving for consistent chemistry throughout the pool.
In Florida specifically, the curing phase is more demanding than in most states. High calcium hardness in Central Florida’s water supply, intense UV exposure, and year-round temperatures that accelerate chemical reactions create a startup environment that requires active management, not passive waiting. A pool that cures correctly in those conditions is a pool that will look and perform as it should for its full lifespan. A pool that doesn’t have problems that no amount of maintenance chemistry will fully correct later.
The four weeks of startup are not a delay. They’re the finish line of the project — and the foundation of everything that comes after.
What Can Delay Pool Resurfacing And What It Means for Your Timeline
Nobody plans for delays. But in Florida pool resurfacing, a few specific factors can extend the timeline in ways that are worth knowing about before the project starts, not after.
What the shell reveals during surface removal.
The most common source of unexpected timeline extension is what the contractor finds once the old surface comes off. Cracks, delamination, or deterioration that wasn’t visible from the outside can require additional repair work before the new surface can be applied. This isn’t a failure of the initial estimate, it’s a consequence of the fact that the shell can only be fully inspected once it’s exposed. A contractor who finds structural issues and addresses them properly before applying a new surface is doing the job correctly. One who proceeds without addressing them is setting up the new surface to fail prematurely.
Weather during the application phase.
Florida’s afternoon storms don’t check your project schedule. Rain during the application of a new finish before the material has set can cause streaking, uneven texture, and in some cases adhesion problems that only become visible later. D&J monitors forecasts closely during any active project and adjusts the application schedule if a system is developing. This is one of the reasons the October through February dry season produces more predictable project timelines — weather-related delays in that window are significantly less likely.
Material selection and certification requirements.
PebbleTec and Quartz finishes have specific application requirements that affect scheduling. As a certified PebbleTec applicator, D&J follows the manufacturer’s protocol precisely which includes conditions that must be met before application begins. If conditions aren’t right on a scheduled day, the application waits. That discipline adds a variable to the schedule but protects the finish from a compromised application that would fail before its time.
Chemistry complications during startup.
A rain event during the startup period, an unexpected issue with local water chemistry, or a surface that’s releasing more minerals than typical can extend the time before the pool is cleared for use. These situations are manageable; they just require adjustment, additional testing, and sometimes extended brushing schedules. The startup isn’t a fixed 28-day countdown. It’s a process with a target, and the target is a fully stabilized surface and balanced water, not a specific date on the calendar.
How Florida Weather Impacts Every Phase of Your Pool Resurfacing Project?
This is the variable that out-of-state contractors and homeowners who’ve had pools in other climates tend to underestimate.
Florida doesn’t just have weather — it has weather that changes the rules of the project at every phase.
During application: Humidity affects how cementitious finishes are set. High humidity slows the initial surface cure and can cause inconsistent bonding if not accounted for in the application process. Florida’s dry season October through February provides the lower humidity conditions that allow PebbleTec and Quartz finishes to cure most consistently. Summer application is workable but requires tighter scheduling around the daily afternoon storm window that makes June through September so unpredictable.
During the fill: Temperature affects fill time and initial water chemistry. A pool filling in January has different starting chemistry than a pool filling in July the water temperature, the rate of evaporation, and the initial mineral load all shift with the season. None of these are unmanageable, but they’re variables that an experienced Florida contractor accounts for and a less experienced one might not.
During startup: Florida’s hard water high in calcium and minerals creates a more demanding startup environment than most of the country. The combination of high calcium hardness in the water supply and high temperatures that accelerate chemical reactions means the startup period in Central Florida requires more active chemistry management than a similar project in a cooler, softer-water climate. Daily brushing, frequent testing, and precise chemical adjustments during the first two weeks of startup are not optional here; they’re the standard the surface requires.
During curing: Intense UV exposure in Central Florida accelerates the surface hardening process in some respects and creates additional evaporation load in others. A pool losing water to evaporation faster than expected during startup may need water added to maintain the chemistry balance which in turn affects the startup protocol. This is normal in Florida. It’s manageable when expected. It’s a problem when it catches a homeowner or a contractor off guard.
The short version: Florida’s weather makes every phase of pool resurfacing more variable than in most states. That’s not a reason to avoid the project, it’s a reason to choose a contractor who has been managing these variables in Central Florida for over a decade.
Can You Speed Up Pool Resurfacing? The Honest Answer.
Yes and no. And the distinction matters more than most people realize when they’re sitting three weeks into a startup wondering if there’s a way to clear the pool faster.
What can be legitimately compressed:
Scheduling efficiency. A contractor with an organized crew and well-managed materials can move through the draining, removal, repair, and application phases without unnecessary gaps between steps. Some contractors schedule work in ways that introduce delays between phases that have nothing to do with the requirements of the project crew availability, material delivery timing, or simply poor project management. A well-run project moves at the pace the work requires, not slower.
What cannot be compressed without consequences:
The curing period. The chemical startup. The daily brushing schedule during the first two weeks. These phases exist because the surface needs time to bond, to harden, to stabilize in the water chemistry. Cutting the startup short by adding excess chemicals to accelerate the process doesn’t speed up curing. It stresses a surface that is still hardening, creates chemistry imbalances that take longer to correct than the time “saved,” and in some cases causes staining or scaling on a brand-new finish that is difficult and expensive to address.
We’ve seen the results of startup processes that were rushed. They don’t save time. In the end they create problems that extend the total time before the pool is usable and in some cases require professional remediation of a surface that should have had years of service left in it.
The honest answer for Florida homeowners:
The best way to “speed up” a pool resurfacing project is to schedule it during the dry season when weather delays are minimal, humidity conditions support faster and more consistent curing, and the startup runs without rain events disrupting the chemistry. A well-timed dry season project moves as fast as the work legitimately allows. A summer project carries variables that can extend every phase.
If you’re working backward from a specific date— a summer party, a family visit, a school break — the right move is to start the conversation with D&J early enough that the full timeline fits without pressure on any phase of the process. A project that has room to be done correctly is always faster, in the end, than one that was rushed.
Why Pool Resurfacing Is Necessary in Saint Cloud FL
How Pool Resurfacing Works Step by Step
Best Pool Finishes for Saint Cloud Homes
How Much Does Pool Resurfacing Cost in Saint Cloud FL?
Signs You Need Pool Resurfacing
Why Hiring a Local Contractor Matters
How Pool Resurfacing Works Step by Step
The process includes draining, surface removal, structural inspection, repair, and application of a new finish. Each step ensures long-term durability and proper bonding of materials.
Expert Insight from D&J
In Central Florida, most resurfacing failures come from improper preparation, not materials. Proper surface bonding and curing time are critical for long-term durability.
Common Mistakes Homeowners Make
- Waiting too long to resurface
- Choosing cheapest material instead of best long-term option
- Hiring non-certified contractors
- Ignoring early surface damage
FAQ
How long does pool resurfacing last in Florida?
It depends on the finish. The material you choose at the start determines how long you’ll go before the next resurfacing conversation.
Traditional plaster: typically lasts 7–10 years in Florida’s climate.
Quartz: finishes extend that to 10–15 years.
PebbleTec: the most durable option and the finish D&J is certified to apply lasts 15 to 20 years or more with proper maintenance.
Is PebbleTec worth it in Saint Cloud?
Yes, due to durability and resistance to Florida conditions.
Can I swim immediately after resurfacing?
No, curing and chemical balancing are required.
What is the best finish for Florida pools?
PebbleTec or quartz finishes.
How often should resurfacing be done?
Every 10–15 years depending on usage.
Ready to Resurface Your Pool in Saint Cloud?
Transform your pool into a durable, modern, and beautiful space built for Florida living.
